Location: 4464 W. Plano Pkwy, Plano, TX
System Size: 600kW (4 x 150kW modular system)
Goal: Fully operational, revenue-generating, grid-connected ultra-fast charging station

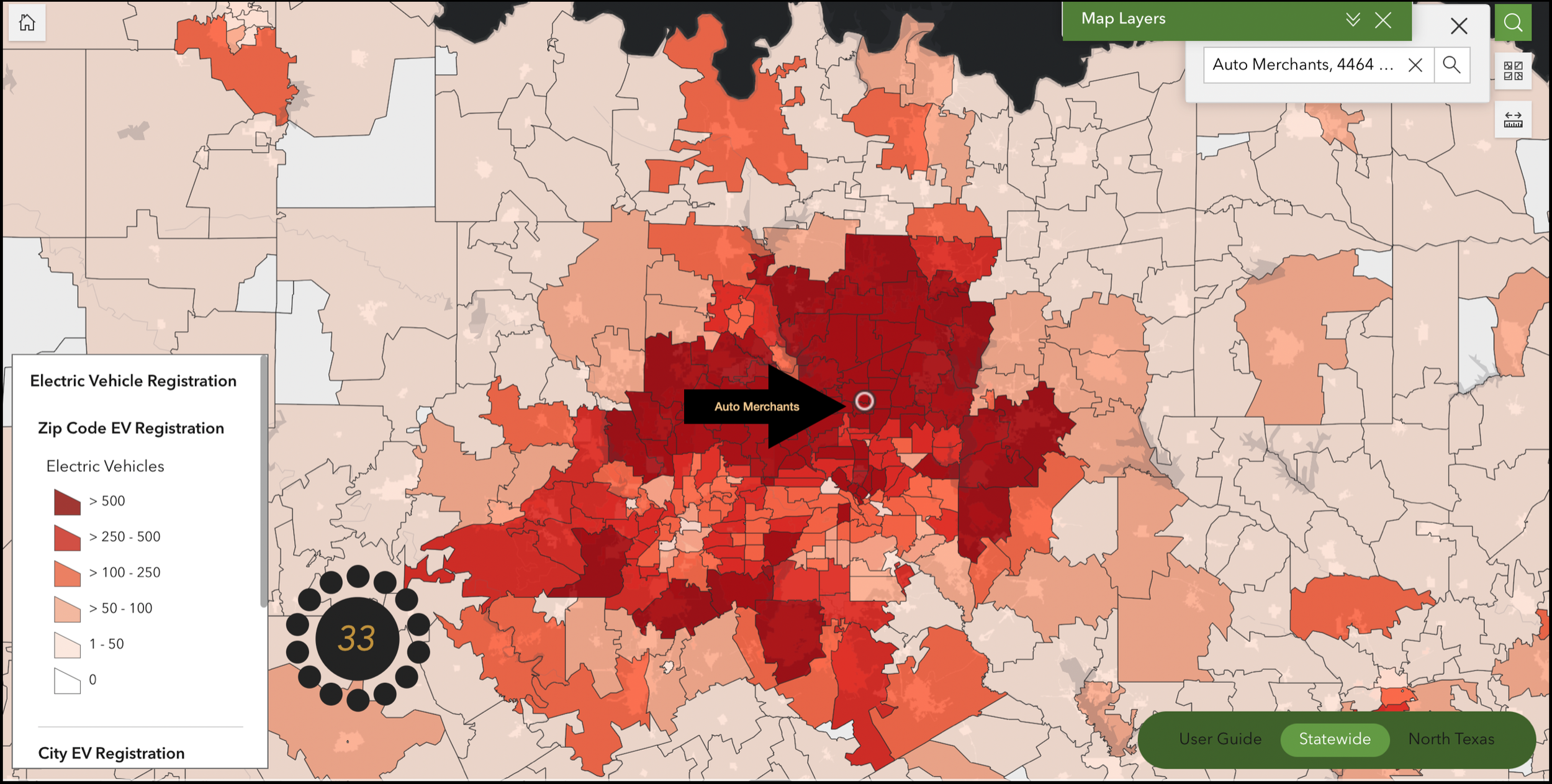

Overall Feasibility Score: 33/40 (High Interest)
The property at 4464 W. Plano Pkwy presents a strong opportunity for EV charging infrastructure, given its strategic location, ample space, operational compatibility, and supportive city infrastructure.
Timeframe Growth rate
Month 1-6 12-18 sessions/day (5-10%)
Month 7-12 25-35 sessions/day (10-15%)
Month 13-24 40-55 sessions/day (15-25%)
Month 25-36 60-80 sessions/day (25-30%)
Revenue Projections (Based on $0.55/kWh, Avg. 35kWh per session)
Year 1: $250K - $500k
Year 2: $500K - $800K
Year 3: $1M +
⚡️ Installation Process ⚡️
Phase 1: Feasibility Assessment
Owner: Project Manager (PM), Utility Liaison
✅ Conduct topographic and civil survey of property
✅ Perform load study and utility capacity check
✅ Validate zoning/commercial code compliance
✅ Coordinate with Oncor to start new service process
✅ Prepare site readiness for MEP
🛠️ Deliverable: Feasibility report and site readiness checklist
Phase 2: System Design & Permitting
Owner: Project Manager (PM),Engineering firm, City Liaison
⚙️ Electrical load and layout design (conduits, transformers, panels)
📐 CAD plans for trenching, pad mounts, solar (if included), canopies and signage
🗂 Submit permit packages for:
Electrical
Civil
Structural (if canopies or enclosures are added)
📝 Secure approvals from local fire marshal and building inspectors
🛠️ Deliverable: Approved stamped construction plans, permit application
Phase 3: Procurement & Pre-Construction
Owner: Procurement Manager, GC, OEM Rep, Project Manager (PM)
🔌 Place orders for:
600kW of DC fast chargers (4 x 150KW)
Power cabinet(s), switchgear, meter/main panel
Network controller + hardware
🛒 Schedule delivery of pads, bollards, trenching gear, and signage
👷 Select GC and electrical subcontractors
📅 Lock in construction schedule with OEM support
🛠️ Deliverable: All components ordered, contractor mobilized,
Phase 4: Civil & Electrical Construction
Owner: GC, Electrical Contractor, Utility Crew, Project Manager (PM)
🚧 Mobilization, fencing, and safety setup
⛏ Trenching for conduits, transformer pads, power cable runs
🪛 Pour pads and mount chargers
🔌 Install switchgear, meter panel, and communications
🧰 Pull wiring, set transformers, integrate rectifier.
🛠️ Deliverable: Physical installation complete, pre-commissioning checklist signed
Phase 5: Utility Interconnection & Commissioning
Owner: Utility Rep, OEM, Project Manager (PM)
📞 Schedule meter set and transformer energization with Oncor
⚡️ OEM team arrives for system commissioning and power-up
🔄 Test each charging port for uptime, speed, payment, and safety
📲 Test PulsePoint integration, remote monitoring, CX features
🛠️ Deliverable: Full system go-live, signed off by city and utility
Phase 6: Launch Preparation & Operations
Owner: Marketing Lead, Ops Manager
📢 Finalize signage, paint striping, station lighting
🎯 Promote launch date across channels
💳 Validate customer workflows: QR scan, app launch, payment, support
👥 Train on-site staff if applicable
🔁 Monitor first-week load and uptime
🛠️ Deliverable: Charging station live and public-facing, launch press ready
